Marquee Hire Software: Why a Saturday Wedding Is a Six-Day Booking
A caller wants a 30x60 frame tent for a graduation party on Thursday, October 22. You check the calendar. The only entry that week is a wedding on Saturday the 24th, so Thursday looks open and you quote it.
It isn't open. That tent leaves the yard Wednesday for the wedding, goes up Thursday and comes down Monday the 26th. The only day on the calendar was the day with guests in it.
Closing that gap is the first job of marquee hire software. A party rental order of tables and chairs goes out for a weekend. A tent job ties up a structure, a crew, a truck and somebody's backyard for most of a week, and the customer thinks they're paying for one evening.

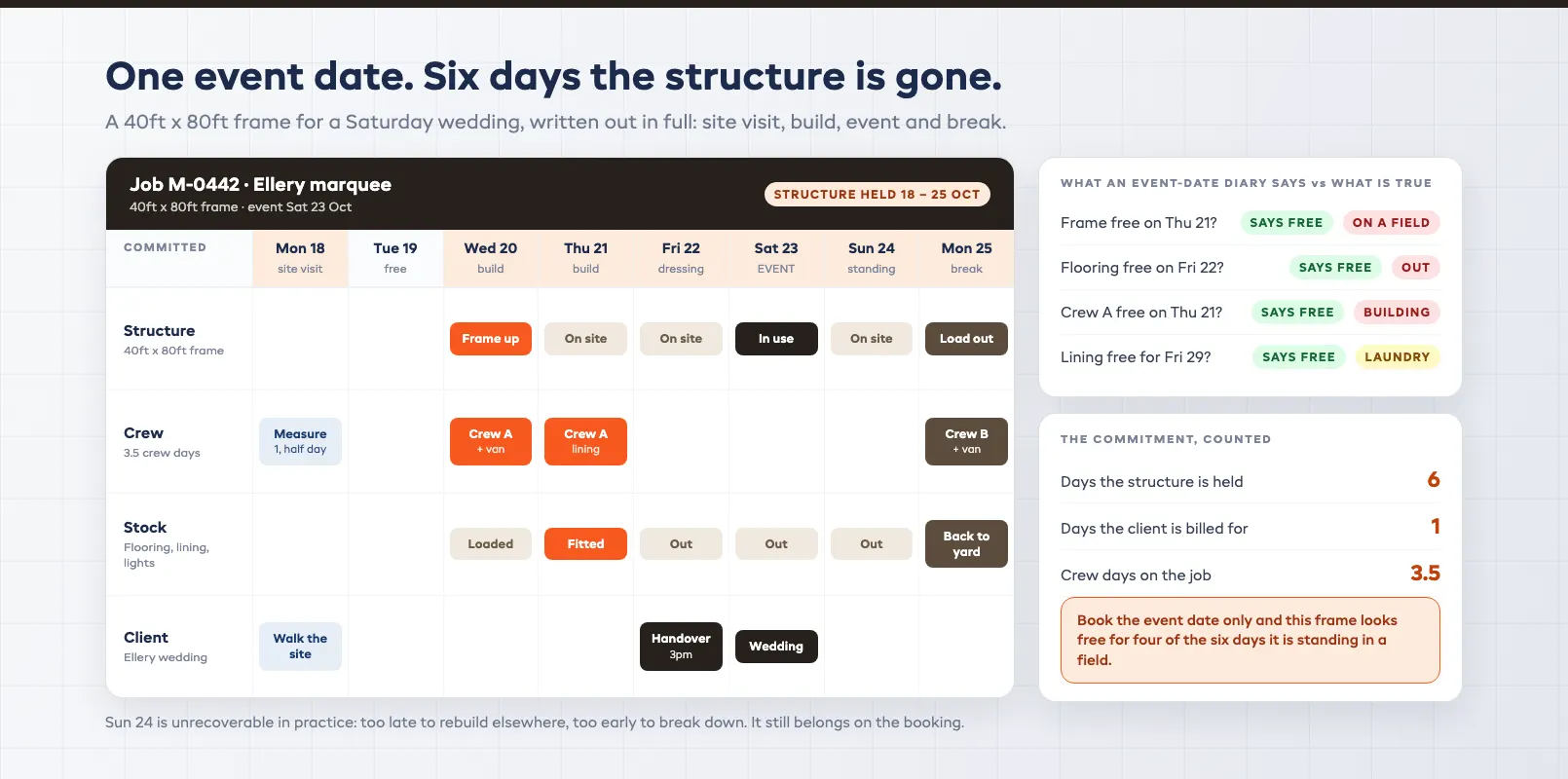

The Booking Is Six Days Long, Not One
The unit of work in tent rental is the whole commitment: load-out, install, the event and the strike. For a mid-size frame tent at a backyard wedding that's usually five to seven days. A county fair or a three-day festival can keep a big structure out for two weeks.
Here's the wedding from that phone call, written down in full:
| Day | What happens | What's tied up |
|---|---|---|
| Wed, Oct 21 | Pull the top, sidewalls and poles; load the truck | Tent, liners, floor, lighting, truck |
| Thu, Oct 22 | Install the frame and top | Tent, Crew A, truck |
| Fri, Oct 23 | Liners, floor and lighting; walk-through with the client | Crew A, floor, lighting |
| Sat, Oct 24 | Wedding | Tent on site |
| Sun, Oct 25 | Tent stays up while the family clears out | Tent on site |
| Mon, Oct 26 | Strike, load and back to the yard | Crew B, truck |
Wednesday is your day in the yard, not the client's, but the tent is just as gone. Nobody else can have it from Wednesday to Monday, or the floor, liners and lighting that went with it.
A smaller job can be tighter: up Friday, down Sunday night. That gets the tent back a day early, but you're paying a crew to work Sunday night, and plenty of families and venues want the tent standing overnight. Ask which it is at the quote, not on Saturday.

In a lot of shops the install days live in a cell comment on the bookings spreadsheet, or on the warehouse whiteboard. Whoever picks up the phone on Tuesday and gets asked about the 30x60 for Thursday doesn't see either.
The booking has to hold the tent for every day it's physically gone. In tent and marquee rental software like EquipDash, you can book the rental from the Wednesday load-out to the Monday strike, or set Buffer time on the tent itself (before and after each booking, in minutes, hours or days) so every booking of that tent blocks its install and strike days without anyone remembering to.
In peak season your biggest tents will look half booked, because a 30x60 out Wednesday to Monday can only do one event that week.
For the wider version of this problem, see how rental shops stop double bookings.
The stock that goes with the frame
The tent gets the inquiry, but the order is usually longer than the tent. Floor, liners, drapes, tables, chairs, lighting, generators, heaters for a January evening reception, and portable AC for a hot early-fall one. It all leaves on the same truck and comes back on the same one, so it's tied up for the same six days.
In EquipDash you can list the liners and floor as contents of the tent and link each one to its own rental product. A linked, item-tracked part gets its own unit assigned when the tent is booked, and it's held for the booking's dates.
Liners and sidewalls also come back dirty or wet. A set that came back Monday isn't ready for Friday until it's been hosed, dried and folded, and after a wet weekend the drying rack is the slowest step in the yard.
If your system counts it as available the moment it's checked in, you'll sell the same liners to two weddings a week apart. Give the liner product its own Buffer time, before each booking for the load-out and after it for the strike plus the wash and dry, so the set stays blocked until it's back on the shelf.
The same goes for linens and other party rental stock, and there's more on wash and dry times in turning event rental stock around between jobs.

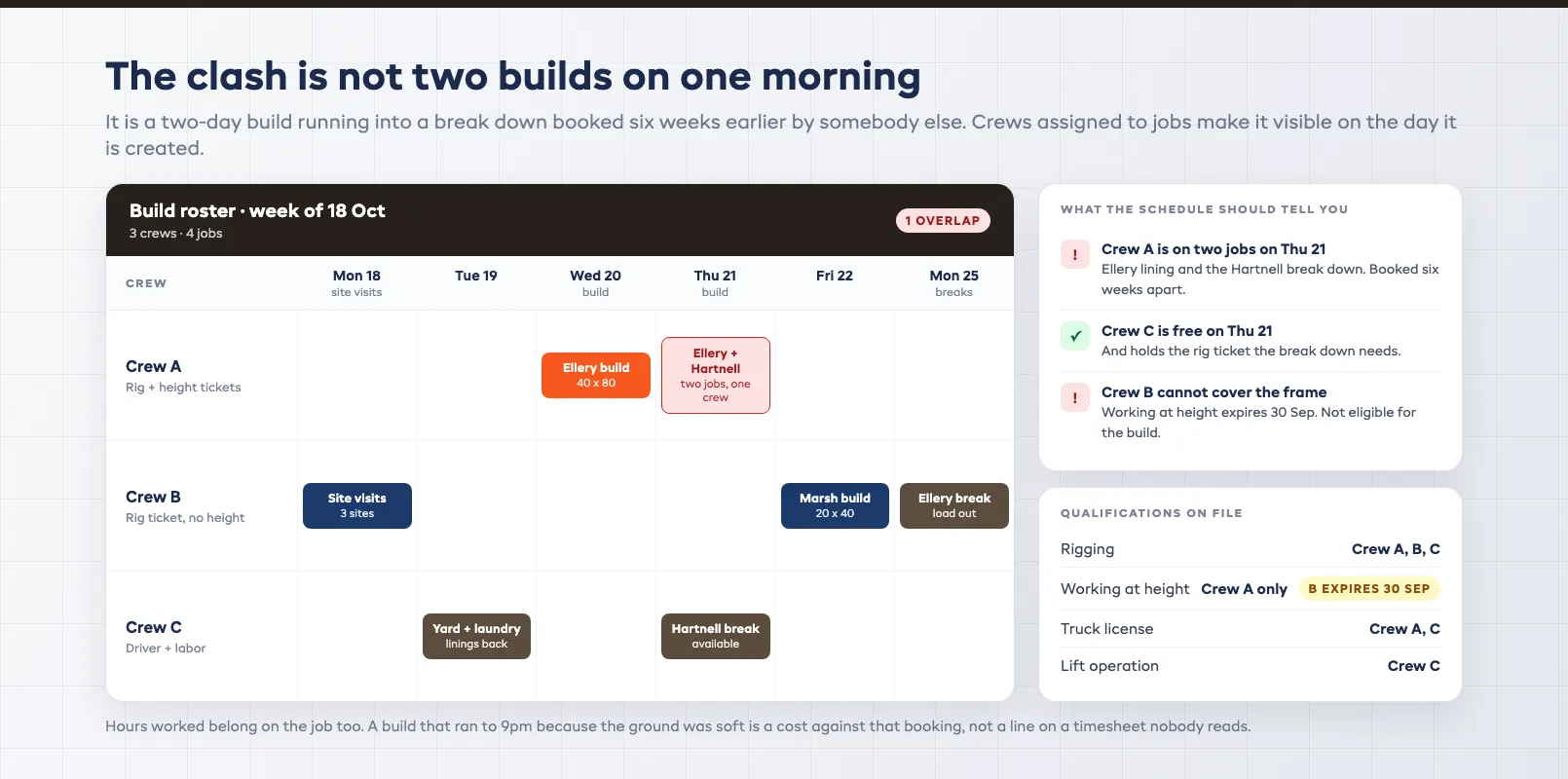

The Frame Is Booked. Is the Crew?
The tent is on the bookings calendar. The crew is on a whiteboard, a group chat or a roster somebody else keeps. The two only meet on install morning.
A shop roster only has to say who's in on Thursday. A tent roster has to say which job each person is on and whether they can legally drive the truck there.
Crews follow the job. Knowing Crew A is "on Thursday" isn't enough when they're on the backyard install until 4, on liners Friday, and need the gate code. If the install moves, so does Crew A's week.
Not everyone can do every job. A single truck rated at 26,001 pounds or more needs a Class B CDL to drive, which is why many 26-foot box trucks are rated just under that line. Forklift operators need training, with an OSHA re-evaluation at least every three years.
Each of these cards has an expiry date. If nobody is watching them, the first person to notice a lapsed one may be an inspector or your insurer.
Clashes stay hidden until they're urgent. Two installs on the same morning get caught. The one that slips through is an install that runs Thursday into Friday and a Friday morning strike, given to the same crew by two different people weeks apart, and nobody notices until Friday at 6am.
In EquipDash, each assigned shift on the Schedule belongs to one person on one date, and you write the job in the shift notes. EquipDash won't save a shift that overlaps one that person already has.

Certifications sit on each person's profile with an expiry date: Driver's License is one of the built-in types, and a forklift card goes in as Specialty Endorsement or Other. Anything expired or due within 30 days shows on the Dashboard and in a Monday morning email to admins. There's more on rostering install teams in scheduling install crews against the job.
You can also set up a Dash bot by describing it to Dash, then have it run every Thursday and email you next week's installs and strikes from the bookings. To get the crew their week, publish the Schedule, and EquipDash emails each affected team member their shifts.
Then there's overtime. Patio installs are where it hides: ballast and water barrels instead of stakes, and a crew that clocked in before dawn still there at 9pm. Under federal overtime rules, time and a half starts past 40 hours in a workweek, so three long installs can put a crew over by Wednesday.
On a paper timesheet, nobody sees that until the week is over. In EquipDash, crew clock in and out on a shared tablet with a 4-digit PIN, and they tap in and out of breaks so break time comes off their hours. Timesheets total each person's actual hours, so you can check them against the shifts they were scheduled for instead of waiting for payroll to tell you.
Site Visits Belong on the Job
Any tent that goes up on ground you haven't seen is a gamble. The visit is where you find the slope, the sprinkler heads, the pool deck, the gate a 26-foot truck won't fit through, and the 130 feet of cable nobody quoted for. It's also where you learn whether you're staking into dirt or ballasting on a patio or hardpan, which changes the truck load, the crew and the price.

Before anything gets staked, call 811 or your local dig-safe line to get the buried utility lines marked.
Put the call and the mark-out date on the job, because the stakes go in on install day whether or not anyone remembered.
Site visits get lost because they don't look like bookings. Sales goes out on a Tuesday weeks before the job, the visit goes in someone's personal calendar, and the notes stay in their phone. The install lead finds the sprinkler heads on install day.
In EquipDash the findings go in the Booking notes card on the booking itself: gate width, ground surface, where the power is, which sprinkler heads to flag. The install crew reads them on the same booking they're working from.
Anything the visit turns up (a generator, extra cable, ballast instead of stakes) goes on the quote before the customer accepts, so it doesn't become an argument afterward. If the visit takes a crew member's afternoon, give it a shift on the Schedule so the time shows up.
On install and strike day, the EquipDash app keeps working with one bar of signal or none. The crew can mark items out and back, with condition notes and damage photos, and it all syncs when the phone is back in coverage.
Permits and the fire marshal
Most US cities adopt the International Fire Code, often with local changes. Under its tent chapter, a tent over 400 square feet usually needs a permit, and the fire marshal wants a certificate showing the top and sidewalls meet the flame test in NFPA 701. A 30x60 is 1,800 square feet, so it's well over the line.
Find out at the site visit who pulls the permit, you or the client, and whether the fire marshal inspects before the event. If there's an inspection, it's one more date that moves when the install does.

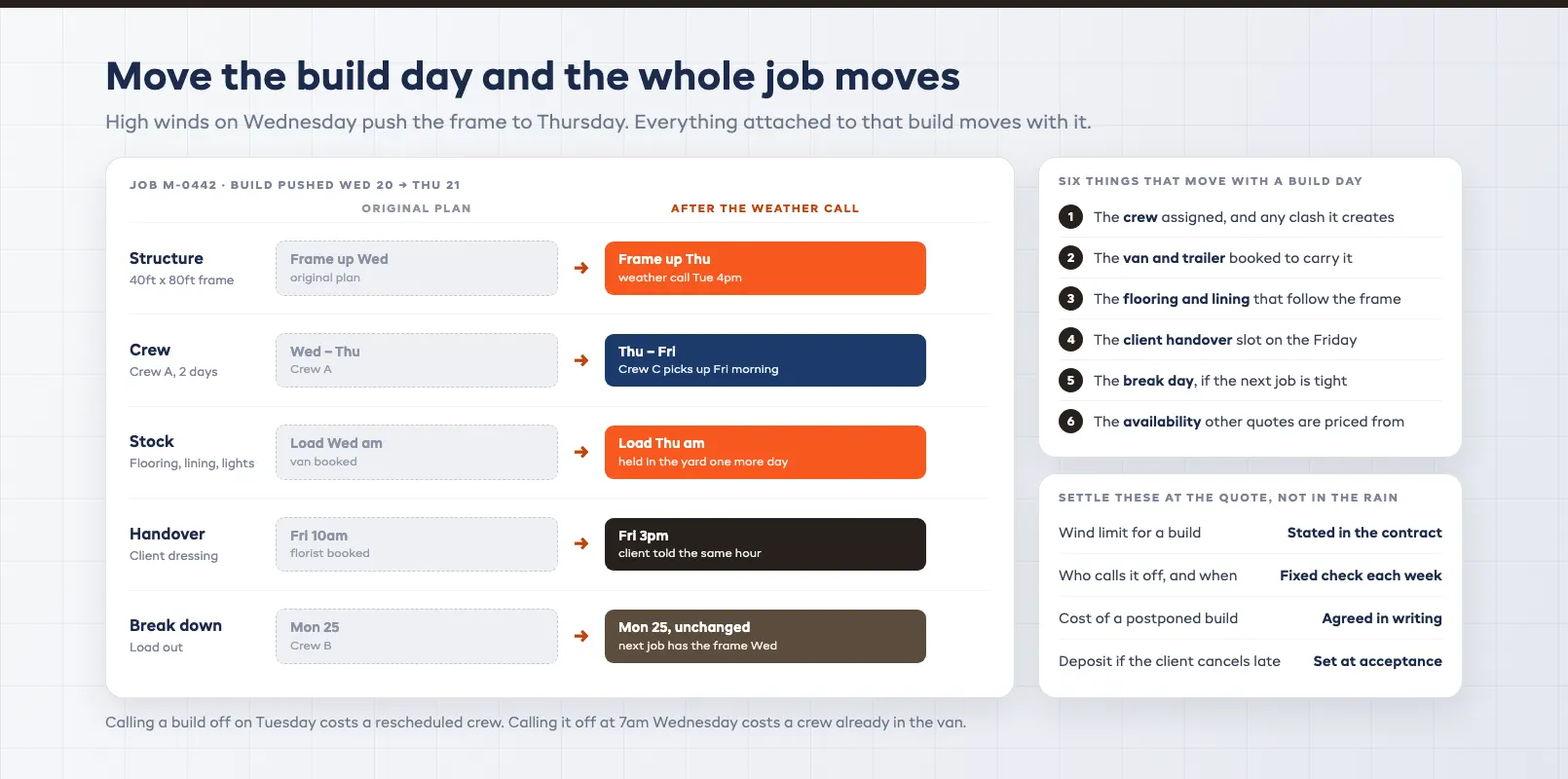

When the Build Day Moves
Wind is the usual reason. A frame tent has a rated limit, and the forecast for gusts can change between morning and afternoon.
In Arizona the monsoon officially runs June 15 to September 30, and the National Weather Service says outflow from strong storms can push gusts of 50 mph or more, usually in the afternoon.
Elsewhere it's a soaked field the truck can't drive on. A tent that can't go up Thursday goes up Friday, and that's when you find out how loosely the rest of the job was tied to it.
Move an install by a day and all of this moves with it:
- The crew on that install, who may now clash with something else
- The truck and trailer
- The floor and liners that follow the frame
- The walk-through with the client
- Sometimes the strike, if the next job is tight behind it

In EquipDash, moving the booking's dates moves the tent and everything booked with it, buffer days included. Then drag the crew's shifts to the new day on the Schedule. If that person already has a shift that overlaps the new time, the drop is blocked with a message, so you find the clash at your desk instead of in the driveway.
Put the wind terms in the contract the client signs with the quote. The limit is the gust speed the manufacturer rates that frame for, with the anchoring you'll actually use on that site. Write down that the call is yours and not the planner's, and who pays when the install moves a day.
The deposit question will come up too, so answer it in writing: what the client gets back if they cancel after the truck is loaded. There's a fuller template in writing a rain and weather policy for weekend rentals.
Then pick the time the day before when the call gets made, and keep to it. It has to be early enough that nobody has loaded the truck yet. Text the crew leads first, then the client or planner.
A call on Tuesday afternoon costs you a reshuffled crew. A call at 7am Wednesday means paying a crew that's already standing in a driveway with a truck of poles.

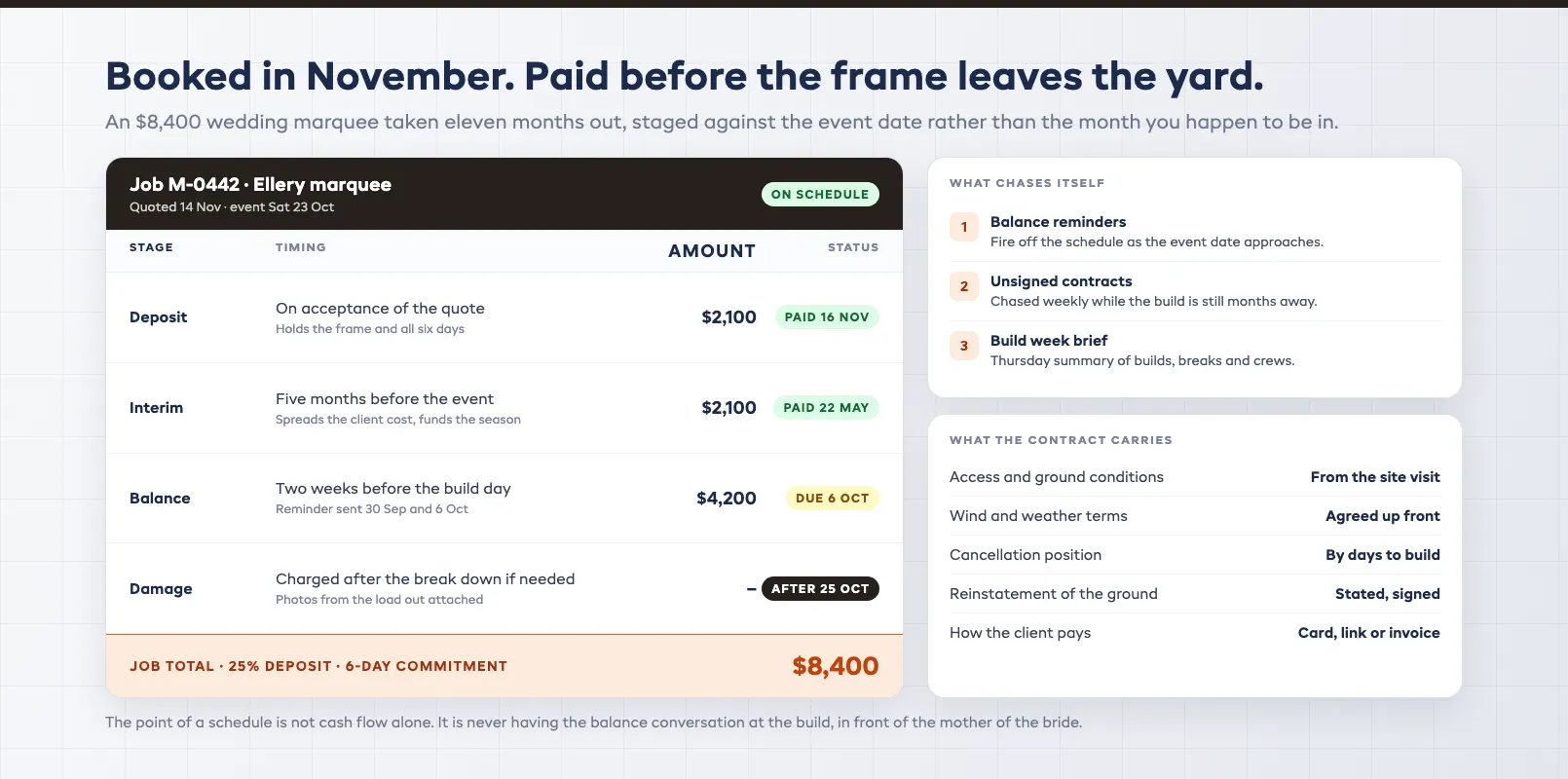

Quoted in November, Paid Before July
Tent bookings are long-lead and high-value. Wedding tents are often booked soon after the date is set, many months ahead. That's a long time for anyone to remember a balance is due, and in most small shops that anyone is the owner.
A staged schedule tied to the event date works better than one tied to the calendar month:
| Stage | Typical timing | Purpose |
|---|---|---|
| Deposit | On acceptance of the quote | Holds the tent and the dates |
| Interim | 3 to 6 months before the event | Spreads the client's cost, funds your season |
| Balance | 2 to 4 weeks before the install | Paid before the tent leaves the yard |
Say the 30x60 job comes to $6,000 with the floor, liners and lighting. A 25% deposit is $1,500 at acceptance, an interim payment of $1,500 a few months out, and $3,000 two weeks before the install. You have the money before you pay a crew to build anything.

In EquipDash, you send a quote and can tick Hold these dates, which blocks the tent while the client decides. If the quote expires or is declined, the dates free up on their own. The client accepts on the quote page and, if you require payment on acceptance, pays the deposit right there.
For the interim, send a payment link from the booking. For the balance, set Remaining balance collection to Auto-charge before booking in Settings, Payments, and pick how many days before the booking.
That shop-wide setting charges the balance on every booking with an online deposit, quotes included, to the card the deposit was paid with. If the card is declined, the client is emailed a payment link instead, while there's still time to chase it before install day.
You can also turn on the Balance Due Reminder text. More on spacing the stages in payment schedules for wedding rentals.
Alongside the weather terms above, the contract should say who pays for lawn, sprinkler or patio damage.
Attach your terms to the quote so the client signs them before they can accept. The rental agreement for the booking is signed by email or on the confirmation page, and the signed PDF stays on the booking.
Resorts and other venues often want a certificate of insurance naming them as additional insured, and your agent needs time to issue it. Ask for the venue's deadline at the quote and give it its own date on the job, separate from the balance. Quoting the full tent commitment covers how to price the six days in the first place.
What to Check Before You Pick Marquee Hire Software
Ask the vendor to do this live in the demo, on a week that looks like yours: book a tent for a Saturday wedding, then try to quote the same tent for the Thursday before. If the screen offers it, you'll double-sell it.
- Can a booking block a tent across install and strike days? If the answer involves a workaround, a note field or booking the event three times, it isn't built for this.
- Can crews be put on a specific install on specific days? Named people, on the days they're working, with the job attached.
- Do crew clashes show up when they're made? Overlapping shifts should be stopped at the moment someone creates them.
- Are licenses and certifications tracked with expiry dates? CDLs and forklift cards lapse without anyone noticing.
- Do site visit notes reach the crew? On the booking, where the install crew will read them.
- Does moving an install date move the rest of the job? Move one in the demo and watch what follows.
- Are floor, liners, furniture and lighting booked on the same job as the frame? Separate lists mean separate mistakes.
- Is cleaning time blocked as downtime? Liners that are back but still on the drying rack must not be bookable.
- Can payments be staged against the event date and collected automatically? On a booking taken a year out, this is where the money goes missing.
- Does the crew app save a check-out with no signal? Condition notes and damage photos included, synced later. One bar at the far end of a ranch is normal.
- What does a peak month cost? Ask for one number for a month with your real number of jobs: subscription, booking fees and card processing together.
- How do the jobs you've already sold come across? Next season's weddings are booked. Ask whether they import or get typed in, and who does the typing.
For question 11, EquipDash plans are $29, $69 and $149 a month, plus a 2%, 1.5% or 1% platform fee on direct online bookings that you can pass on to the client. Staff scheduling and Dash bots start on the $69 plan. Quotes, with held dates and payment on acceptance, are on the $149 plan.
Card processing is on top: Stripe's standard US rate is 2.9% + 30¢ per card charge, so a $3,000 balance costs about $87.30 to collect. Full detail is on the pricing page.
To see how the tent, crew and payments sit on one job in EquipDash, start with EquipDash for tent and marquee rental.
FAQ
What is marquee hire software?
Marquee hire software, or tent rental software as most US shops call it, tracks which tents are out and on which days, who is on each install, what has been quoted and what is still unpaid. It differs from general rental software in one way that matters: a booking holds the tent for the install and strike days as well as the event. So the calendar shows the tent gone all week, where a general system shows only the day of the party.
Why does a one-day event block a marquee for six days?
Because the tent has to be loaded, installed, dressed, left standing through the event and then struck. A larger wedding tent can be loaded Wednesday, go up Thursday, get liners and lighting Friday and come down Monday. A smaller job might go up Friday and come down Sunday night.
Either way the tent, floor, liners and lighting are gone for the whole window, and a calendar built around the event date shows them as free while they're in someone's backyard.
How should build and break days be handled in a booking system?
Put them on the booking itself, so they block the tent. Either book the rental from load-out to strike, or set buffer time on the tent so every booking blocks its install and strike days on its own. That way the calendar shows the tent as gone on the Wednesday and Thursday, quotes are built from real availability, and moving the booking moves the blocked days with it.
How do you stop crews being double-booked across two builds?
Put each crew member's shift on the schedule with the job in the notes, and use a system that refuses an overlapping shift for the same person on the same day.
The clash that slips through is usually an install that runs into a second day, against a strike someone else booked weeks earlier. When the overlap is blocked at the moment someone creates it, you find it at your desk. Publishing the schedule then emails each crew member their shifts, so the whole crew works from the same plan.
What happens to a booking when weather forces a build to move?
Everything attached to the install has to move with it: the crew, the truck, the floor and liners that follow the frame, the client walk-through, and the strike if the next job is tight behind it. If the tent and its stock sit on one booking, moving the dates moves them together and you only have to move the crew's shifts.
If they live in separate calendars and spreadsheets, it takes an afternoon of phone calls and something gets missed. Settle the commercial side in advance too: the wind limit, who makes the call, cancellation terms and who pays for a postponed install, written into the signed contract.
How should payments be structured for a wedding booked a year in advance?
In stages tied to the event date rather than the month you happen to be in. A deposit on acceptance holds the tent and the dates, an interim payment a few months out spreads the client's cost and funds your season, and the balance falls due a couple of weeks before the install so the tent doesn't leave the yard unpaid. Set the balance to charge automatically, or at least send a reminder off that schedule, because a balance due in July on a booking taken last November is not something anyone should track in their head.
Can flooring, linings and furniture be booked on the same job as the frame?
They should be. Floor, liners, drapes, furniture, lighting, heaters and power leave on the same truck and are tied up for the same days as the tent, so booking them on the same job keeps the package together. Liners need one extra rule: block them as downtime while they're washed and dried, so a set that came back Monday isn't offered to a client for Friday before it's back on the shelf.
Do marquee companies need site visits scheduled in the system?
Yes, for two reasons. A site visit is time someone spends, usually the owner or a salesperson, and it belongs on the schedule so it shows up.
The findings need to reach the install crew, who are often different people turning up weeks later: gate width, ground surface, sprinkler heads, power, and whether utility lines have been marked through 811. Anything the visit turns up that costs money should reach the quote before the client accepts, not become an argument afterward.
in one place
